BYRON SHIRE COUNCIL

Late Reports                                                                                                                          17.1

Late Reports

Report No. 17.1     Response to the "No Traffic Lights in Suffolk Park" Petition &  Project Update

Directorate:                         Infrastructure Services

Report Author:                   Euan Rose, Infrastucture Planning Coordinator

Samuel Frumpui, Manager Works

File No:                                 I2025/308

Summary:

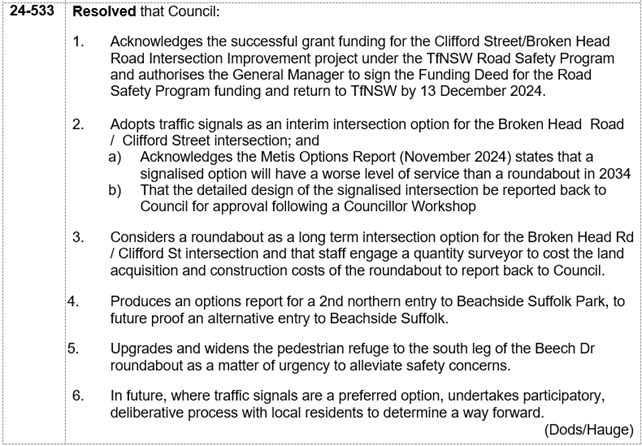

This report provides an update regarding Council Resolution 25-035 (shown below) concerning the intersection of Broken Head Road / Clifford Street in Suffolk Park, specifically addressing the community’s preference for a roundabout instead of traffic signals and the next steps based on discussions with Transport for NSW (TfNSW).

In summary, due to the reasons outlined in the body of this report, it is recommended that Council either proceed with traffic lights and the actions identified in Council Resolution 24-533 (shown below) OR terminate the current funding agreement and commence investigation into a roundabout and land acquisition with appropriate budget allocation.

RECOMMENDATION:

That Council:

Proceed as per Council Resolution 24-533 and continue with the current signalised intersection upgrade project and make adequate plans and investigation for a long-term intersection option of a roundabout for the Broken Head Road/ Clifford Street intersection.

Report

1. Acknowledgement of the Petition

Council acknowledges receipt of the petition opposing traffic signals, with 1,091 signatures in support of a roundabout as the preferred intersection treatment.  This feedback has been considered in ongoing discussions with TfNSW.

2. Urgent Engagement with TfNSW

a) Seeking advice on grant variation requirements under the Road Safety Program

As per Clause 10 (Variation) of the Funding Deed, Council has formally notified TfNSW of the intent to submit a Change Request Form and has sought confirmation on whether a roundabout meets the Road Safety Program funding criteria.

·    TfNSW has advised that any scope change must demonstrate comparable or superior safety outcomes to the originally approved project scope and objectives.

·    TfNSW has advised that a scope change can be submitted but will need to be assessed under the current program funding criteria.  Any scope change will need to be delivered by 31 March 2026.

The current program of delivery and completion for the signalised intersection is at jeopardy of meeting the completion date of 31 March 2026, if a decision is not made to proceed as per Res 24-533 and the engagement of civil designers to commence.

b) Exploring the feasibility of a roundabout for safety improvements

Council has sought confirmation from TfNSW on whether a single-lane roundabout at this regional road intersection can meet the program’s safety objectives.

·    A full-sized roundabout would require land acquisition, which would impact project timelines and funding requirements.

·    The 2016 TTM Traffic Analysis Report previously identified that designing a single-lane roundabout compliant with current applicable standards and specifications would likely require additional land acquisition.

c) Notifying TfNSW of Council’s intent to seek a grant variation

A formal request has been submitted to TfNSW (5/03/2025), identifying a roundabout as the preferred long-term treatment (as per Council RES 24-533).

·    Council’s request references Austroads’ New and Emerging Treatments Part 7 and the NSW Road Safety Action Plan as justification for considering a compact roundabout.

·    TfNSW has indicated that design constraints, vehicle movement assessments, and funding limitations must be carefully considered.

d) Exploring a speed reduction to 40 km/h

TfNSW has advised that a speed reduction to 40 km/h at this location is unlikely to be supported under the Speed Zoning Guidelines.

·    Broken Head Road functions as a high-movement corridor, and existing traffic data indicates that the current 50 km/h speed limit is operating effectively, with an 85th percentile speed of 57 km/h.

·    However, TfNSW has acknowledged that a roundabout itself could act as a speed-calming measure, reducing approach speeds.

·    Council has requested further assessment of whether reducing the speed limit would:

o Allow for a more compact roundabout design, potentially eliminating the need for land acquisition.

o Enhance pedestrian and cyclist safety, addressing key concerns raised in the 2025 Traffic Modelling Supplementary Report and 2016 Road Safety Audit.

e) Assessing the suitability of a low, traversable mini roundabout

Council has sought TfNSW’s technical input on the feasibility of a low, traversable mini roundabout as an alternative solution that may eliminate land acquisition requirements.

·    This option would need to consider:

o Accessibility for buses, trucks, and caravans through adjusted splitter island geometry.

o Ensure compliance with heavy vehicle swept path requirements while maintaining safety outcomes.

o Meet the safety objectives for vulnerable road users under the Road Safety Program.

·    TfNSW has indicated that vehicle movement constraints and operational safety must be carefully assessed in any roundabout design.

f) Feasibility of rapid design and construction within grant timelines

Council has completed extensive traffic modelling and safety assessments, including:

·    Metis Traffic Modelling Report (2024)

·    TTM Traffic Analysis Report (2016)

·    TTM Road Safety Audit (2016)

Council has asked TfNSW to confirm whether:

·    Existing studies are sufficient for decision-making, or if additional detailed modelling is required.

·    Additional TfNSW approvals or review processes would be needed before endorsing the change.

Design and Implementation Timeframes & Costs

Mini roundabout

·    Concept design will take approximately three weeks from consultant engagement, with an estimated cost of $8,500.

·    Detailed design to IFC (Issued for Construction) will take approximately four (4) months.

·    Delivery will take approximately six (6) months.

·    Depending on TfNSW approval timeframe under the current funding program, this option would be tight, with no float, to deliver by 31 March 2026.

Full-size roundabout

·    Concept design will take approximately three (3) weeks from consultant engagement, with an estimated cost of $11,500.

·    Detailed design to IFC will take approximately seven (7) months, considering:

o Significant service relocation works to accommodate the increased footprint, leading to extended design and delivery lead times and additional costs.

o Likely requirement for a Part 5 DA under the SEPP due to its expanded scope and potential environmental impacts.

·    Delivery could take up to ten (10) months, contingent on a detailed design

·    This option could not be delivered by 31 March 2026.

g) Officially requesting a grant extension

TfNSW has confirmed that no extensions will be granted beyond 31 March 2026.

·    The Australian Government Road Safety Program Guidelines clearly state that risks such as extreme weather, unexpected delays, and other disruptions must be incorporated into project planning.

·    Any change request must ensure the project remains fully delivered by this deadline, including submission of the Project Completion Report by 15 April 2026.

·    If the project cannot be delivered within this timeframe, it must be withdrawn.

TfNSW has also advised that any funding increase request exceeding the original P90 value ($2,329,912) will be assessed at the time of the change request and subject to remaining Road Safety Program funding.

Additionally, a TfNSW Road Safety Program Change Request review period for a variation of this nature could take up to 10 weeks for TfNSW to review and approve.

3. Urgent Land Acquisition Estimate

Council has prioritized obtaining land acquisition estimates to assess the financial and spatial feasibility of a full-sized roundabout.

·    Land acquisition will be dependent on developing a compliant concept design to determine the required acquisition extents (as noted in the 2016 TTM Traffic Analysis Report).

·    If a mini roundabout is deemed feasible, land acquisition may not be required.

·    The property valuation process for land acquisition, should owners agree to terms, is expected to take approximately 4-6 weeks to complete.

Current Project Considerations

The current program of delivery and completion for the signalised intersection is already at jeopardy of meeting the completion date of 31 March 2026’ if a decision is not made to proceed as per Res 24-533.  The current program of works detail engagement of designers this week to commence on detailed design scopes, and to allow staff to meet critical milestones.

Strategic Considerations

Community Strategic Plan and Operational Plan

CSP Objective

CSP Strategy

DP Action

Code

OP Activity

5: Connected Infrastructure

5.3: Invest in renewable energy and emerging technologies

5.3.1: Future needs - Plan for the infrastructure needs of the current and future population

5.3.1.11

Traffic, Transport and Active Transport Capital Works Business Cases Development

Recent Resolutions

·        24-533

·        25-035

Legal/Statutory/Policy Considerations

Not applicable.

Financial Considerations

As noted in body of report.

Furthermore, Council has committed to date $147,000 towards the project, which would be at cost to Council should the Grant Funding be terminated.  Consideration towards all the current investigative works (e.g. survey, pavement design, service locations) and other planning works should be relevant for a period, before further works are required to ascertain any changes.

Consultation and Engagement

A mechanism will be established to allow community members to register their interest and participate in further consultation.

Regular project updates will be provided as Council works through technical and funding considerations.

Options

1.   That Council proceed as per Council Resolution 24-533 and continue with the current signalised intersection upgrade project and adequately plan for a long-term intersection option of a roundabout for the Broken Head Road/ Clifford Street intersection.

Or

2.   Terminate the current TfNSW Road Safety Program grant funding agreement, acknowledging the funding implications that will impact Council.

Authorise staff to commence land acquisition processes and other pre planning investigations into the roundabout treatment options with an appropriate funding source identified and report back to Council.

That funding for the expenditure incurred to date on the intersection project and for future planning be considered at the next Quarterly Budget Review
