Report

Purpose

This report provides a high-level project design for the delivery of evidence-based recommendations for Council to decide on a future water supply strategy for Mullumbimby.

The project in question responds to Council Resolution 24-477 (see Attachment 1)

Staff request the Committee to provide feedback and advice for ensuring the project design is fit-for-purpose.

Note: Council’s Executive Management team have transferred responsibility for the delivery of this project to the Assets & Major Projects Team.

Background

Mullumbimby’s water supply is sourced from the Lavertys Gap weir, situated in the upper reaches of Wilson’s Creek.  The weir feeds the Mullumbimby Water Treatment Plant (WTP), which then supplies potable water to the town’s water network.

Various elements of this scheme were commissioned between the 1920s and 1940s.

It also included a small hydroelectric plant, but was decommissioned in 1989.

Due to its location, condition and design, the Lavertys Gap weir / Mullumbimby WTP scheme is vulnerable to droughts and extreme weather events, and in the face of Mullumbimby’s future development estimates, it is predicted the scheme will not be able to meet Mullumbimby’s water demand beyond 2028.

In situations when the Lavertys Gap weir / Mullumbimby WTP scheme fails (e.g. during droughts or wet weather) Council can operate a supplementary water source through the Rous Emergency Water Supply Line.  This scheme connects Mullumbimby to the Rous regional water network, with current capacity to cover approximately half of the town’s water demand.  The emergency line was built in response to the 2002-2003 drought. Following the 2022 floods, Council secured State Government funding to upgrade the emergency’s line capacity to be able to cover all of Mullumbimby’s reticulated water demand.

In recognition of these issues, since 2019 Council staff have produced a substantial body of work aimed at informing a long-term water supply strategy for Mullumbimby (see Attachment 2). Various water supply options were assessed, with the resulting recommendation being to permanently connect Mullumbimby to the Rous regional water supply via the existing emergency supply line. This recommendation was adopted by Council in August 2024 (Res. 24-411, Attachment 3).

However, in October 2024, Council decided to defer the decision for an additional two years to allow for further investigations and community consultation while addressing the ongoing risks to the Lavertys Gap weir / Mullumbimby WTP scheme (Res. 24-477, Attachment 1).  This latest Resolution is the catalyst for the project described in this report.

Project design

Staff are undergoing project design to enable an evidence-based and transparent decision-making process to secure long-term water security for Mullumbimby.  Lessons learnt are being distilled from the previous round of work and the deliberation process that resulted on Council’s Resolution 24-477 (Attachment 1).  Staff are also concerned with the ongoing structural, performance and compliance shortfalls of the Lavertys Gap weir / Mullumbimby WTP scheme, which are further compounded by the rising risk of extreme weather events and Council’s financial constraints and capital investment priorities across the Shire’s water supply systems.

Thus, considering the complexity of the above issues, it is of paramount importance that Council staff and decision makers agree on why this project is needed, what it is aiming to achieve, and how it will do so, as well as recognising the constraints and risks that influence it.

The sections below articulate a proposed project design to facilitate this agreement.

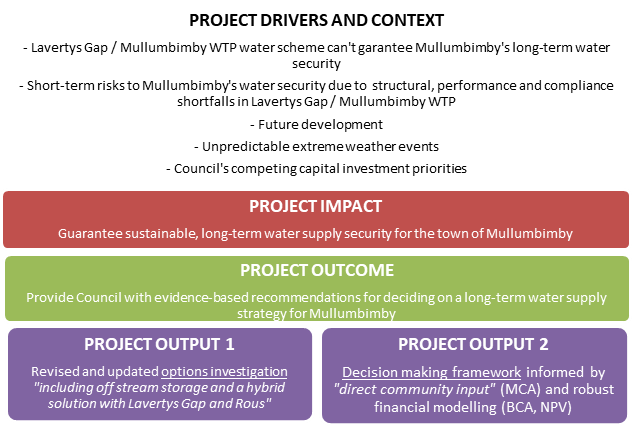

Project conceptual framework

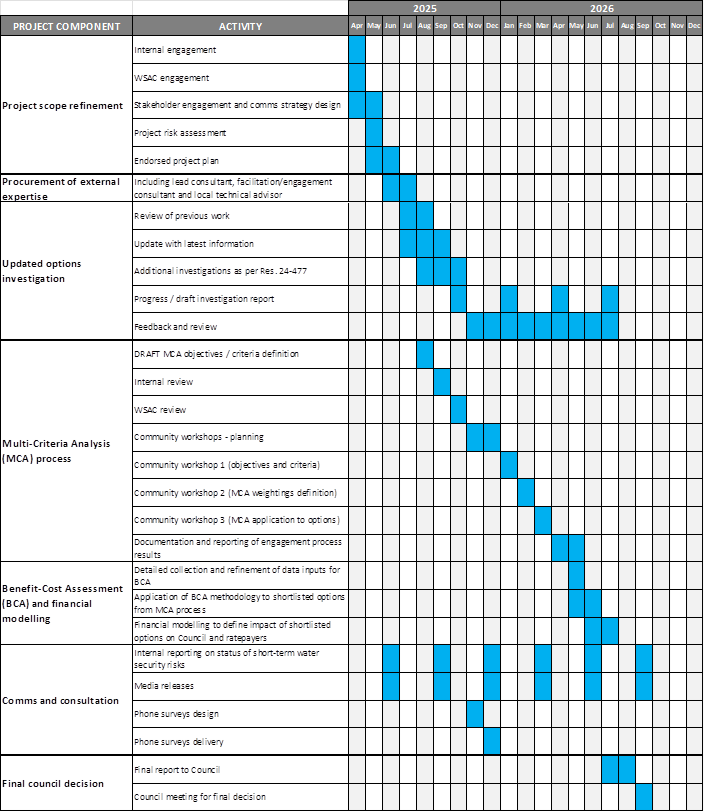

Figure 1 below presents the proposed project at a conceptual level. It establishes the desired impact (i.e. guarantee sustainable, long-term water supply security for the town of Mullumbimby), and works backwards to describe the project outcomes, outputs, actions and resources that will support that impact. Project drivers and contextual issues are also described.



Figure 1 – Project conceptual framework

Project assumptions

-     Previous investigations (see Attachment 2) will be reviewed and used as a key input for this project.



-     Off-stream storage option: while this option was already explored in previous investigations, additional comment and high-level/desktop assessments will be provided regarding:



§ possible sites for an off-stream storage

§ hydrology, water quality and catchment impacts

§ environmental flows considerations

§ considerations regarding landholder consultation and land acquisition



-     Hybrid water supply option: this new option assumes the combined operation of the Lavertys Gap water source and the Rous regional water supply (via the upgraded Rous Emergency Supply Line), offering enhanced water security and operational flexibility.  This may involve the downsizing and/or relocation of the Mullumbimby WTP to reduce risks associated with extreme weather, treatment performance and regulatory compliance.



-     Mullumbimby’s future water demand estimates will be revised and updated in alignment with the latest growth forecasts (i.e. Byron Shire Residential Strategy 2041).



-     Item 4.c. of Res. 24-477 (Attachment 1) requests that the reinstatement of hydroelectric facility be explored as part of this investigation.  High-level commentary can and will be provided around this issue.  It is expected however that given the site’s heritage significance (and related constraints), water licence considerations, governance arrangements, and Council’s service provision and capital investment priorities, this option will not feature in this study.



-     Decision making framework: The process for shortlisting options and ultimately recommending a water supply solution to Council will be multi-staged:



§ Stage 1: Options shortlisting through Multi-Criteria Analysis (MCA) based on community-designed objectives, criteria and criteria-weightings. Community input will be facilitated via a series of workshops.

§ Stage 2: Shortlisted options will then go through a Benefit-Cost Assessment (BCA) to assess their economic viability (i.e. benefit/cost ratio). The assessment will follow BCA guidelines from NSW Treasury.

§ Stage 3: Net-Present Value (NPV) of shortlisted options over a 30-year timeframe will provide the basis for understanding the financial impact on Council, and ultimately, the ratepayer.



Other metrics may be defined to assist Councillors on their final decision, and could include estimated rate increases, dollars per kilolitre of water supplied ($/kL), etc.

Project risks

Staff considers important risks impacting the delivery of this project to be clearly defined and understood across stakeholders.  While a comprehensive risk assessment is proposed to be done early on the project timeline, an initial description of some key project risks is provided below.  Staff hopes to use this as a springboard to further unveil project risks in collaboration with the WSAC, and support the upcoming risk assessment process.

-     The capital costs of some options to be investigated may exceed Council's and the community's capacity to fund it (via rate increases). This risks the long-term condition of water provision assets and levels of service to the community.

-     Unpredictable weather events, the high-risk nature of Wilsons Creek catchment, and the end-of-life condition of the Lavertys Gap weir / Mullumbimby WTP scheme hinder Council’s capacity to maintain water security and comply with relevant regulation until a final decision is made and implemented.

-     Recent revised growth forecasts for Mullumbimby are likely to increase future water demand estimates, changing water supply options’ capacity modelling.

-     The State Heritage listing of Mullumbimby Hydro-electric Power Station Complex. This includes the weir but not the treatment plant. There will be additional approvals required to modify or upgrade the weir.

-     Community’s willingness to pay for proposed options is yet to be understood.

-     Misinformation / disinformation in the community throughout this project may impact efforts to drive evidence-based decision making.

Project interdependencies

Achieving a decision on a long-term water supply strategy for Mullumbimby and safeguarding short-term water provision may be influenced or constrained by other Council activities/projects, including:



-     Rous Emergency Water Supply Line upgrade project: This is currently ongoing, with completion expected by September 2025.  Regardless of what long-term water supply strategy Council decides on, completion of this upgrade is critical to enable that strategy, either as the main water supply moving forward, or as the redundancy required to allow for the implementation of other long-term solutions. It will also offer interim water supply security in case the Lavertys Gap weir / Mullumbimby WTP scheme fails before a long-term strategy is adopted.



-     Negotiation of Level of Service Agreement (LSA) with Rous: As requested in item 3 of Res. 24-477 (Attachment 1), Council’s executive team, with support from Utilities staff, are in negotiations with Rous to facilitate a reduction of the emergency water supply volumetric charges.  This important to help reduce the financial impact on Council if Lavertys Gap weir / Mullumbimby WTP fails and/or reliance on the Rous Emergency Supply Line increases in the short term.



-     Lavertys Gap weir condition assessment, monitoring and repairs project: Council’s Utilities Department, with the support of NSW Public Works, is undertaking actions to address bank erosion issues that put at risk the weir’s structural integrity, and consequently, its storage capacity.  The key focus is on condition monitoring until final remediation works can be done. These are only possible once the upgraded Rous Emergency Water Supply Line is operational. Wet weather events can hinder these efforts.



-     Mullumbimby WTP short-term improvements: Following advice from NSW Health, Council staff are investigating operational controls and treatment process upgrades to manage non-compliance risks at Mullumbimby WTP.  These risks relate to the high-risk nature of the Wilson’s Creek catchment and the design and end-of-life condition of the WTP, and might trigger boil water alerts if advised by the regulator.



-     Securing water supply for Wilson Creek residents: There are 13 properties in Wilsons Creek directly connected to the Mullumbimby WTP trunk main.  These connections are not compliant with Council’s current Water Supply Operations Standards and land zoning rules, but it is understood this is a legacy issue going back to the establishment of the Mullumbimby WTP.  The properties have become reliant on the potable water supply for rural water security, with a high level of water consumption.



It is expected that potable supply to the above-mentioned properties will need to continue (item 6, Res. 24-411, Attachment 3). In the short term, supply from the WTP is at risk due to the issues described in the above sections, and Council will need to find alternative water sources if required (e.g. trucking water to the WTP’s clear water tank).  In the long-term, if Council decides to favour the Rous supply, upgrades to water conveyance and storage systems will be required to enable supply to the Wilsons Creek residents.




Project draft plan

A high-level draft implementation plan is provided below.  This plan will be refined following consultation with the WSAC.


















































Strategic Considerations

Community Strategic Plan and Operational Plan

CSP Objective

CSP Strategy

DP Action

Code

OP Activity

5: Connected Infrastructure

5.5: Provide continuous and sustainable water and sewerage management

5.5.1: Water supply - Provide a continuous water supply that is maintained in accordance with NSW Health guidelines

5.5.1.20

Report to Council on the future water strategy for Mullumbimby

Financial Considerations

A project budget will be put forward following refinement of the above project design.

Consultation and Engagement

This report is part of the internal engagement and consultation required to refine the above project design.  A detailed stakeholder consultation and engagement strategy is to be developed.

Additional Information

Attachment 4 provides a summary of progress done with regards to the action items of Council Resolution 24-477






BYRON SHIRE COUNCIL

Staff Reports - Infrastructure Services                                                 4.2 - Attachment 1





BYRON SHIRE COUNCIL

Staff Reports - Infrastructure Services                                                 4.2 - Attachment 2













































































































































































































































BYRON SHIRE COUNCIL

Staff Reports - Infrastructure Services                                                 4.2 - Attachment 3





BYRON SHIRE COUNCIL

Staff Reports - Infrastructure Services                                                 4.2 - Attachment 4





BYRON SHIRE COUNCIL

Staff Reports - Infrastructure Services                                                            4.3

Report No. 4.3       Byron STP Wetlands Monitoring Report

Directorate:                         Infrastructure Services

Report Author:                   Cameron Clark, Manager Utilities

File No:                                 I2025/470

Summary:

This report provides a summary of Byron STP wetlands performance in accordance with the STP Operations Environmental Management Plan.







RECOMMENDATION:

That the committee note the report.










Report

Australian Wetlands Consulting (AWC) have been engaged by Byron Shire Council (BSC) to provide operational support and management for the Byron Bay Integrated Water Management Reserve, (BBIWMR).  This report summarises the key activities, actions and key findings.



The BBIWMR includes 15 ha of constructed treatment wetlands and the 24 ha Melaleuca regeneration system within a total site area of 106 ha. In addition to the managed wetland and regeneration areas are lands specifically designated for biodiversity in particular areas managed for frog and grass owl habitat. Refer to Attachment 1 for a plan showing the OEMP management zones



In 2022 AWC reviewed and updated the BBIWMR Operation and Environmental Management Plan (OEMP). During this review of the OEMP the various monitoring and reporting requirements as related to the Byron STP conditions of approval, legislative requirements and environmental management obligations were identified. The key reporting and frequency requirements are summarised in Table 1 – Documentation and Reporting. .

Summary of Key Activities Undertaken 2022-2025

1.   Monthly checklists have been recorded since July 2022, providing knowledge of the site conditions and how it responds to operational and seasonal changes

2.   A comprehensive asset register has been compiled determining the condition of all the components within the treatment wetland complex and Melaleuca regeneration area

3.   A scientific trial of salvinia weevils (Cyrtobagous salviniae) for the control of Salvinia molesta is ongoing with the NSW Department of Primary Industries. December 2022 to June 2026

4.   Development and collaboration with Rous County Council, BSC Bush Regeneration Team and AWC to detect, monitor and control an outbreak of Amazonian Frogbit
(Limnobium laevigatum)

5.   A review and update to the Byron STP Biodiversity Management Plan

6.   A review of Bird monitoring activities in collaboration with Byron Bay Bird Buddies (BBBB)

7.   Bird Surveys (Australasian Bittern, bimonthly bird surveys)

8.   Grass Owl Survey

9.   Cane Toad surveys

10. Feral Animal detection and management

11. Clearing of access and drains

12. Frog Survey (Wallum Sedge Frog and Wallum Froglet)

13. Anabat Survey

14. Installation of Nest boxes (BBBB and Wild BnB)

15. Vegetation Mapping and Monitoring (2023, 2024 and 2025)

16. Development of maintenance and repair lists

Table 1 Documentation and reporting requirements

Summary of Key Management Activities

Table 2 summaries the key management activities and actions in relation to the OEMP and Biodiversity Management Plan and their current status as in April 2025.











Table 2 Management tasks, frequency, location and status April 2025

Management Task

Frequency

Location

Actions and Remediation

Status April 2025

Routine inspection (refer checklist in Appendix D)

Ensure operational areas and public walkways are safe and accessible.

Weekly

Designated monitoring and observation points

Schedule mowing.

Mowing undertaken as required by external contractor.

Notify Operations Engineer of need for any works (e.g. stabilisation works)

Completed June 2022 to March 2025

Maintain dense cover of low grasses and sedges on berm surfaces

Monthly



Constructed wetland cells

Bush regeneration and weed management undertaken as required by external contractor or the BSC regen team

Ongoing condition of edge vegetation has significantly improved

Weed management and bush regeneration)

Monthly



Whole site

Bush regeneration and weed management undertaken as required by external contractor or the BSC regen team

(Refer to West Byron Sewerage Treatment Plant Weed Management Strategy (DM530123))

Ongoing work with DPI as part of weevil trial for Salvinia control. Ongoing work with BSC Bush Regen Team to control Frogbit.

Successful control on Salvinia in Cell H

Facilitate the annual Bird Survey

Annual

Whole site

Ensure records are kept and reports provided to NPWS

Ongoing

Create mudflat habitat and manage water levels in Cell H for bird habitat

Ongoing

Whole site

Refer to Section 4.8 of OEMP

In progress

Communication and engagement with relevant stakeholders

Ongoing

Whole site

Refer to Section 5 of OEMP

Ongoing

Record and monitor plant health and growth

Weekly

Cells D, E, F, G

Cells I and J

Identify areas of poor plant growth or health

Ongoing  - completed June 2022 to March 2025

Seasonal drying of wetland cell floors to allow oxygenation of sediments and germination of wetland plants

Annual

Cells D, E, F, G

Cells I and J

Drain cells slowly and carefully via all outlet valves to prevent erosion, scour and suspending sediments

Close cells requiring maintenance during dry season.

Cells D or E may need to be drained in mid June – July to create mudflats for habitat when wet weather prevents this within Cell H (refer Section 4.8 of OEMP).

Partial success (Cells D and E)

Cells I and J have not been possible  due to operational constraints (weather conditions, weed management requirements and no ability transfer to effluent reuse area)

Replanting of vegetation at outlets1, in areas of poor growth and open water.



Bi-annually

Cells D, E, F, G

Cells I and J

Schedule and arrange for replanting and translocation of healthy plants to areas of poor growth

Ensure appropriate water levels can be provided in planting areas and consider bird protection

Ongoing some trials have been undertaken but the main focus has been weed control

Routine inspection of wetland cells for presence and growth of weeds (refer checklist in Appendix D)

Monthly

Cells D, E, F, G

Cells I and J

Identify and prioritise weed management within the treatment wetland cells

Completed June 2022 to March 2025

Ongoing

Routine inspections (refer checklist in Appendix D)

Monthly

Cell H

Identify, record, and monitor any maintenance works

Completed June 2022 to March 2025

Maintain water level



When water levels drop to 0.45m

Cell H inlet

Maintain water level >0.45m and <1.0m

Top-up cell to 0.65m when water level reaches 0.45m

Completed June 2022 to March 2025

No top ups required

Create mudflat habitat

Annually (in mid June – July)

Cell H or alternatively Cells C and D

1.   Open valves to lower water level to approximately 0.4m to expose mudflats

2.   Allow area to dry

3.   Slash vegetation

4.   Raise water level to 0.8m – 1.0m to kill remaining vegetation

If wet weather prevents the creation of mudflats in Cell H, Cell D or E shall be drained to create mudflats.

Ongoing has been partially completed. Increase in waders and waterbirds in Cells D and E

Maintain wet season water level of 0.8m

Wet season

(~Nov-Mar)

Cell H

To prevent inundation of plants and loss of habitat

Complete

Maintain water quality

As required

Cell H

Top up cell following significant rainfall events (>25mm/day)

Not required due to climatic conditions

Remove weeds

3 monthly

Cell H

Refer to West Byron Sewerage Treatment Plant Weed Management Strategy (DM530123)

Ongoing

Routine inspection (refer checklist in Appendix D)

Monthly

24ha area

Identify, record, and monitor any maintenance works

Completed June 2022 to March 2025

Ongoing

Manage weeds within the 24ha

Monthly

24ha area

Identify, record, and monitor any required weed management tasks

Completed June 2022 to March 2025

Ongoing

Monitor groundwater quality

Continuously

Groundwater monitoring wells

Refer Appendix C

Record pH, conductivity and temperature

Completed June 2022 to March 2025

Ongoing

Monitor groundwater levels

Continuously

3 x Groundwater monitoring wells Refer Appendix C

Record groundwater levels to inform irrigation application and to manage ASS

Completed June 2022 to March 2025

Ongoing

Maintain groundwater levels above 600mm below ground level (BGL)

Monthly

Groundwater monitoring wells

Refer Appendix C

Increase irrigation when ground water level drops below 600mm

Completed June 2022 to March 2025

Ongoing

Fluctuate the water table level by 300mm increments

3 monthly

Groundwater monitoring wells

Refer Appendix C

Reduce surface pyrite formation during periods of waterlogging

1.   Raise water table to 300mm (BGL) for one month

2.   Raise to surface and maintain for three months

Completed June 2022 to March 2025

Ongoing

Minimise surface ponding

Monthly

Irrigation area

Avoid irrigating following rainfall events

Not applicable

Maintain pH below 5.2



Groundwater monitoring wells

Lower the water table when pH approaches 5.2

Completed June 2022 to March 2025

Ongoing

Maintain pH above 3.5



Groundwater monitoring wells

Raise the water table when pH approaches 3.5

Completed June 2022 to March 2025

Ongoing

Record observations of threatened species

During site inspection or when sighted

All areas of the BBIMWR

Record and document threatened species occurrence on the site

Completed June 2022 to March 2025

Ongoing



Ensure contractors and visitors receive the necessary training and communicate the requirement to protect frog and owls on the site

Ongoing

All areas of the BBIMWR

Provide induction and training to contractors and site visitors

Ongoing

Manage weeds and feral species to prevent impacts to habitat

Ongoing

All areas of the BBIMWR

Bush regeneration and weed management undertaken as required by external contractor or the BSC regen team

(Refer to West Byron Sewerage Treatment Plant Weed Management Strategy (DM530123))

Completed June 2022 to March 2025

Ongoing



Ensure that works are ceased in the event of grass owl detection

Ongoing

All areas of the BBIMWR

Follow Grass Owl Protection Procedure as detailed in 4.10.1

Completed June 2022 to March 2025

Ongoing

Undertake required monitoring of threatened fauna

Annually

Targeted Locations in the BBIWMR

Update Biodiversity Management Plan

Complete June 2022 to March 2025



Category

Performance criteria

Status April 2025

Constructed Wetlands (D, E, F, G, I & J)

·    Emergent weeds and invasive natives are controlled and comprise ≤5% total cover within each cell

·    Native macrophyte vegetation is dense and healthy (>80% coverage of native macrophytes >80% of the time)

·    Cell batters where access to operational infrastructure is not required are densely vegetated

·    Emergent and floating weed cover in Cells D and E <5% total

·    Emergent and floating weed cover in Cells F ang G and I and J exceed performance criteria

·    Cells batters where access is not required are densely vegetated

·    Native macrophytes dominate Cells D and E

Cell H

·    Contains all of the following wetland habitats:

o Open water with floating macrophytes (bottom and middle of cell)

o Native emergent macrophytes (top and edges of cell)

o Native woody vegetation on the north-eastern berm only

o Mudflats (from August – March inclusive)*

·    Emergent weeds and invasive natives are controlled and comprise ≤5% total cover within each cell

·    No decline in plant species diversity

·    Cell batters where access to operational infrastructure is not required are densely vegetated

·    Predatory native fish populations such as Eel and Mullet are present

·    Minimum water depths required for Comb-crested Jacana are maintained

·    Works avoided in Cell H during Jacana breeding season

·    Open water in bottom and middle of cell with floating macrophytes

·    Emergent weeds (including floating) and invasive natives cover in cell H <5% total

·    Native emergent macrophyte coverage (top and edges of cell) stable and healthy

·    Native woody vegetation on the north-eastern berm only

·    Mudflats to be developed from August 2025

·    No observed decline in plant species diversity

·    Cell batters where access is not required are densely vegetated

·    Predatory native fish populations such as eel and mullet present

·    Minimum water depths required for comb-crested Jacana present

·    Works avoided in cell H during Jacana breeding season



24 Hectare Melaleuca Regeneration Habitat

·    Emergent weeds controlled and comprise ≤5% total cover

·    Optimal water use to maintain plant health and evapotranspiration

·    Emergent weeds controlled and compromise <10% total cover

·    Water use in 24Ha impacted by loss of critical infrastructure and downstream drain condition

Frog and Grass Owl Habitat

·    Emergent weeds controlled and comprise ≤5% total cover

·    Native vegetation continues to persist and structurally provide suitable Grass Owl habitat which is not degraded or disturbed

·    Water chemistry is between a pH range of 3 – 5

·    Emergent weeds controlled and compromise <5% total cover

·    Native vegetation present and healthy providing suitable Grass Owl habitat

·    Water pH between 3-5

Acid Frogs

·    Existing/known habitat areas continue to be utilised by Acid Frog species

·    Native vegetation within Acid Frog habitat areas (constructed wetlands, Frog and Grass Owl Habitat) continues to persist and is not degraded or disturbed

·    Existing/known habitat areas for Acid Frogs continue to be utilized

·    Native vegetation within Acid Frog habitat areas has continued to persist and has not degraded or disturbed

Grass Owl

·    Existing/known habitat areas continue to be utilised by Grass Owls

·    Native vegetation within Frog and Grass Owl Habitat areas continues to persist and structurally provide suitable Grass Owl habitat which is not degraded or disturbed

·    No Grass Owls detected during monitoring surveys

·    Habitat areas persist and further vegetation survey required

Bats

·    Existing/known habitat areas continue to be utilised by insectivorous bats

·    Native vegetation within suitable habitat areas (constructed wetlands, Frog and Grass Owl Habitat and 24ha Melaleuca Habitat) continues to persist and is not degraded or disturbed

·    Bat survey complete

·    Native vegetation supports bat presence on the site

Feral Animals

·    Feral species, particularly Cane Toads do not become established within cells

·    Densely vegetated cell batters maintained

·    Feral animal trapping/control actions are initiated should populations be observed within the BBIWMR

·    Feral Species, cane toads present on the site

·    Densely vegetated cell batters maintained

·    Feral animal trapping/control actions are in place

Threatened Birds

(Comb-crested Jacana, Australasian Bittern, Black-necked Stork, Black Bittern)

·    Populations distributions and abundances of threatened waterbird species are monitored annually, particularly during breeding events

·    Monthly Bird surveys carried out annually to monitor population distributions and abundances of threatened waterbird species, particularly during breeding events

Threatened shorebirds

·    Populations distributions and abundances of threatened waterbird species are monitored annually, particularly during breeding events

·    Monthly Bird surveys carried out annually to monitor population distributions and abundances of threatened waterbird species, particularly during breeding events



Significant Events 2022-2025

A number of significant events occurred at the BBIWMR during the period 2022 to April 2025. These include complete removal of Salvinia from the biodiversity wetland Cell H. (see Figures 1 and 2)

Figure 1 Cell H December 2022 Complete Salvinia Cover

A body of water with trees in the background

AI-generated content may be incorrect.

Figure 2 Cell H January 2023 Salvinia clearance due to weevil control

In October 2023 a large bushfire occurred impacting a significant portion of the site (Figure 3 Extent of fire 2023). Since this time operation of the effluent reuse area has not been possible.



Figure 3 Extent of fire 2023

A comprehensive audit and assessment of the condition of all site infrastructure was undertaken 2023 -2024 (See Figure 4)



Figure 4 Undertaking asset condition assessment in the 24ha regeneration area September 2024

Amazonian frogbit was detected in Cell H and Cells D and E in 2024.

A number of significant rainfall events occurred during the period with conditions generally being wetter than average limiting the maintenance activities that could be undertaken on the site.

Works to be undertaken 2025 – 2026

The following points identify tasks to be undertaken in the next 12-18 months

·    Workshop with BBBB Review of Monitoring (20 years of data, key trends, review of monitoring strategy)

·    Installation of Automated Logging System 24ha and Cell J (Water level, pH)

·    Downstream drain management

·    Assessment of Acid Sulphate Soils and review of ASS Management Plan for the BBIWMR

·    Completion of compliance reporting

·    Continuation of required biodiversity monitoring

·    Further monitoring of vegetation condition

·    Repair and reactivation of 24 Melaleuca Regeneration area

·    Repair and renewal of assets as identified by the asset condition register

Condition of the System Summary

The treatment wetland cells were commissioned as part of the 2006 capital works program and components of the system are now in need of replacement and renewal in order to ensure that the wetland system provides the required polishing function for treated effluent from the Byron Bay STP.

The wetland cell inlets in particular have reached the end of their functional life and are now not providing even distribution of effluent flow across the top of the cells. In a number of locations water depths do not support the establishment of dense healthy aquatic macrophyte vegetation. There is also Acid Sulphate Soils underlying Cell D.

Weed management requirements on the site are significant and require sustained effort to but some areas of improvement are evident particularly Cells D, E and H.

Since the bushfire the operation of the 24ha regeneration area has not been feasible. Much of the infrastructure was completely destroyed.

Condition of Cell H has improved with Salvinia control with more bird activity and Black Necked Storks observed on two occasions.

Migratory bird activity also appears to have improved with Latham’s snipe detected in 2024. Grass Owls were not detected on the site in survey undertaken in 2024.








BYRON SHIRE COUNCIL

For Information Only                                                                                                         6.1

For Information Only



Report No. 6.1       Infrastructure Services Utilities Monthly Status Report December 2024 - February 2025

Directorate:                         Infrastructure Services

Report Author:                   Cameron Clark, Manager Utilities

File No:                                 I2025/434

Summary:

This report summarises the performance of Utilities delivery during the period December 2024 to February 2025.

Recommendation:

That the Committee note the report.










Report

DRINKING WATER QUALITY

In February 2025 there were three (3) exceedances related to turbidity.

January 2025 there were zero (0) and in December 2024 there were two (2) exceedances at Mullumbimby WTP related to level sensor technical faults.



NSW Health Water Quality Monitoring

The tables below detail the performance of the water supply network for 2025.

Incident Reports and Public Health Reportable Events

There were zero (0) Public Health reportable events and NSW Health Sampling non-compliances in February, January 2025.



EPA Reportable Events

There were zero (0) EPA reportable incident during February, January 2025 and December 2024.

ASSET MAINTENANCE MANAGEMENT

Continuous Improvement Actions

Recent Improvements:

1.      Property water meters have already been brought into the system and reactive maintenance tasks are routinely logged against these.  The geographical location of the meters could not be discerned as part of the GIS upload and therefore meters are currently, in general, located in the centre of each lot.  We are currently undergoing a process of relocating each meter to the correct location in line with information held in the Water Billing system. Currently:

a.      Mullumbimby, Bangalow, and Brunswick Heads are complete and service lines have been generated.

b.      Suffolk Park is at approximately 35% completion and will be included in the system in the coming weeks.

2.      Following recent update to the Assetic platform, changes have been made to the Planned Maintenance programming and the Asset catalogue to create separate Work Groups for operational teams. Previously all teams were within one Water and Sewer Work Group, which cluttered workspaces and required complex filtering to avoid seeing all work for all teams. Moving forward, all PM tasks will be generated within their appropriate Work Groups. Team leaders and supervising staff who create work orders for reactive work have been notified of this change.

3.      Because of the live nature of current reporting integrations between Assetic and Power BI, there is not currently a way to look back on the state of the system as it was in any given month in the past. The IT Team have created a series of history tables that will be appended at the end of every month, essentially creating easily reportable snapshots of the Assetic system to track KPIs, as seen below

Next Steps:

1.      Weekly meetings with team leaders were suspended over the Christmas/New Year break and have resumed to drive further improvements to the Assetic System.

2.      With the ongoing effort to digitise and properly catalogue plans and important asset-related documents, the team will soon be uploading more of these documents to Assetic to be easily accessible to field staff when needed.

ASSET MAINTENANCE STATUS

Planned Maintenance – Progress against Program

Overall, Utilities planned maintenance in February is 89.6% tasks completed by due date against a target of 80%. The current long-term average of tasks completed by due date is 86.7%.

Planned versus Reactive Maintenance

The figure below shows the comparative maintenance hours for each team between planned and reactive maintenance. Reactive maintenance has taken 67.0% of all hours spent working on assets for the last 12 months.





CAPITAL WORKS

SPS Renewals for Byron, Mullum, Ocean Shores & Bangalow

SPS



% COMPLETE



PUMPS DELIVERED

SWITCH-

BOARD DELIVERED

COMPLETED SCOPE SUMMARY

SPS 1002

100

N/A

Delivered

Casted new switchboard pad and installed new 3x 63mm electrical conduits and new 32mm mains onto pumps. Switchboard installed. Made good old switchboard plinth and penetrations into well and valve chamber. Restoration completed.

SPS 1005

100

N/A

Delivered

Removed existing broken sealed surface and re-asphalt access road

SPS 1007

100

N/A

Delivered

MH and bypass connection installed. NPE by pass pumps demob. Epoxy works completed and SPS back in operation. Add spindle (SS316) on inlet valve. Replaced risers in PE 125 and replaced lifting chains in SS. Installed new switchboard on new concrete pad (1960x1600x200) with new odour filter and old concrete plinth removed. 3x63mm conduit 16mm electric main installed. Penos with 2 parts mega poxy (5-10mm) concluded. Replaced odour filter to ground mount McBerns filter. Water service to be relocated. Fixed padlock cover on lid. Restoration completed.

SPS 2002

100

N/A

Delivered

Completed replacement of risers PE125 through to the valve chamber, no need for valves. New PE pipe connected directly into valves to save space. New Spindle on SS316 was installed. Restoration completed.

SPS 2004

100

N/A

Delivered

Replace existing DN150 gate valve in the 2002 rising main on outside of well

SPS 2010

100

N/A

Delivered

Replaced risers PE180, DN150 outlet gate valves, check valves, Gibault and flanged spigot. Installed new Switchboard pad (1600x1600x200). 3 x 63mm electrical conduits installed to green boy approx. 120m away. Water Service relocated. Excavation under high water table needed dewatering system. Restoration completed.

SPS 3004

100

N/A

Delivered

Bypass completed, Epoxy Coating and crack injections completed, Standpipe and ductile iron manifold updated to HDPE.

SPS 3010

100

N/A

Delivered

Replaced risers PE125 from elbow on wet well to valve pit, DN150 outlet gate valves, check valves. Relocated water service. Restoration completed.

SPS 3017

100

N/A

Delivered

Replaced inlet gate valve and refurbish inlet pipe penetration

SPS 3021

100

N/A

Delivered

Construction completed. Replaced DN125 risers, DN100 outlet gate valves, check valves, DN150 inlet gate valve, replace guide rails and brackets, relocated water service, removed vent pole and replaced with McBerns odour filter, removed switchboard plinth and replace switchboard. Restoration completed.

SPS 4007

N/A

N/A

Delivered

 Removed from scope

SPS 5003

N/A

N/A

Delivered

 Removed from scope

SPS 5014

100

N/A

Delivered

New switchboard plinth cast done, already installed new 3x63mm conduits to pump well, removing existing conduits and grout. No need to remove part of the fence. New electrical mains from green boy to board completed, new switchboard and commission with electricians had issues but a work around was completed. Running on new switchboard. Restoration completed.

SPS 5017

100

N/A

Delivered

Completed the replacement of the DN125 risers, DN100 outlet gate valves, check valves and dismantling joints, DN150 inlet gate valve and spindle as well as handrail around new switchboard platform. Old platform was removed, switchboard replaced as well as new electrical mains. Water service relocated. Restoration completed.

SPS 5020

100

N/A

Delivered

Completed the install of the 2 x new DN125 PE riser pipes through to the valve chamber, new gate valves and check valves, Gibault and flanged spigots. New gate valve DN150 on incoming gravity sewer. New slab for switchboard (3120x1000x200) was casted. Applied bitumen coat on spigot. Removed the Ladder. Restoration completed.

SPS 5022

100

N/A

Delivered

Installed new switchboard, conduits, electric main and new concrete platform. Removed existing switchboard and concrete plinths and installed new switchboard on new platforms. Pipework is also completed as well as stairs. Relocated water service. Installed new Covers, grill and frames sealed for odour control. Handrails were installed and existing plinth was modified to suit new ground mount odour filter. Restoration completed.

Gravity Sewer Mains Remediation

Based on previous condition assessments of the gravity sewer main network, Willow and Sparrow identified mains that required remediation works to prolong their use and/or to fix acute defects.  The remediation scope included the installation of patch liners, excavation and repair, and CCTV survey.  This package of works was awarded to Subsurface Pipe Solutions to a value of $132,950 plus GST.  Work has commenced and is currently running on schedule. There has been some variation in scope due to previously unknown site and asset conditions which has resulted in lowering the overall budget whilst maintaining the desired outcomes. This project is nearing completion.

Gravity Sewer Condition Assessments

The condition assessment of gravity sewer mains and maintenance holes was awarded to Willow and Sparrow (maintenance holes) and Subsurface Mapping Solutions (mains).  The Maintenance hole condition assessments are underway.  The CCTV mains contract was awarded to Subsurface Mapping Solutions and work is scheduled to be completed by June 30.  The sewer catchments that fall within this scope are across Bangalow, Suffolk Park, and Ocean Shores.  The indicative budgetary limit of ~$320,000 will cover the costs for both CCTV assessments and MH visual assessments. Condition assessment reports for mains and maintenance holes will be completed once all data has been gathered.

Water Main Replacements – Supply and Installation: Fletcher St, Carlyle St and Bangalow Rd Byron Bay; and Azalea St Mullumbimby

Site 01 Carlyle Street – Byron Bay

•        Construction is completed – Planit and CivilCS are to review and finalise WAE and ITPS;

Site 02 Azalea Street – Mullumbimby

•        Construction is completed – Planit and CivilCS are to review and finalise WAE and ITPS;

•        CivilCS to complete final remediation works.

Site 03 Fletcher Street– Byron Bay

•        Construction is completed – Planit and CivilCS are to review and finalise WAE and ITPS;

•        CivilCS to complete final remediation works.

Site 04 Bangalow Road – Byron Bay

•        Construction is completed – Planit and CivilCS are to review and finalise WAE and ITPS;

•        CivilCS to complete final remediation works.



Paterson St Reservoir Replacement

Work accomplished in the period:

•        Michael Salu (SSE) has finalized the structural engineering concept designs (exclusive of stairs).

•        Planit has now issued their Concept Design Plans for Council review.

•        A meeting with the telcos occurred mid-December. Agreement was made to progress the Concept Design to Detailed Design. Council need to review the concept plans and a new fee proposal is required to be submitted by Planit.

Telcos – Paterson: NO CHANGE FROM MAY 2023

•        A meeting was held with BMM Group (who act on behalf of all major Telcos)

•        BSC and BMM have agreed on a concept design for the antenna locations and Telco access to the antennas – being from a Telco gantry off the side of the reservoir, NOT via the BSC stairs and roof.

•        Planit to provide survey and concept design to BMM to allow them to proceed with planning approvals and draft design of the access and antenna connections.

•        Concept structural plans have now been issued to the telecos for comment.

Mullumbimby Emergency Trunk Water Main Construction

Work accomplished in the period:

•        The project has now commenced construction.

•        UGL Regional Linx held a meeting as they required additional information to provide approval. Plans were updated accordingly with the water main being 4.1m deep to accord with their standard requirements.



Ewingsdale Road Water Main

Work accomplished in the period:

•        Planit has now completed the detailed design of this water main, inclusive of the structural engineering design of the water main brackets.

•        ENV Solutions has now completed their ASSMP Report.

•        Plans were reissued to show survey marks.

•        Design now under staff review.

Main Arm Road Concept Water Main

Work accomplished in the period:

•        Project postponed to FYE2027 due to budget resource constraints.
